2023 Green Street

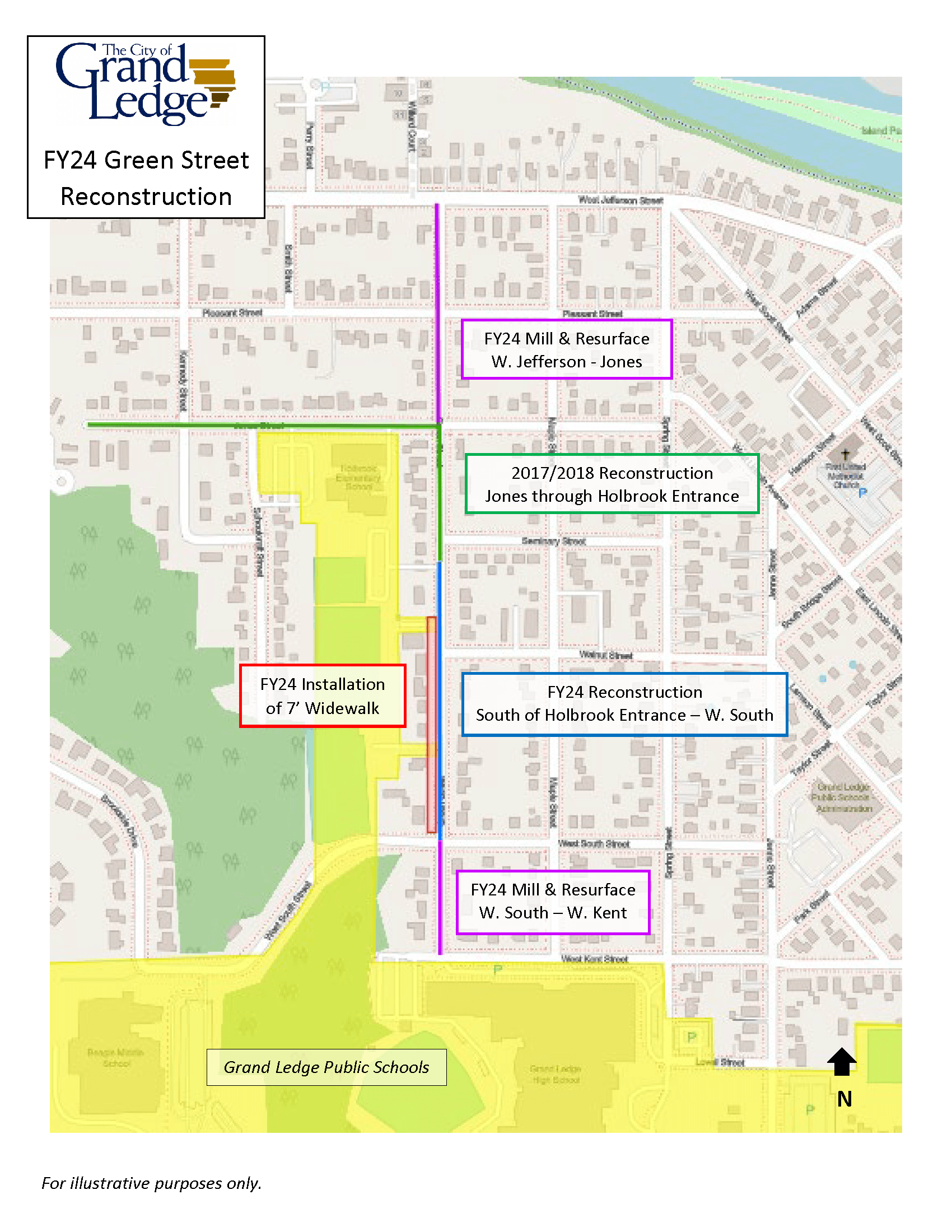

Beginning in late August, Green Street (just south of the new Holbrook entrance to W. South) will be reconstructed. The block of Green Street from W. South to W. Kent will be milled and resurfaced. Three blocks of sidewalk from Jones to W. South will also be renovated into a 7' wide walk. The project is anticipated to be complete by early November.

The project has a construction cost of $1,256.091.50 which was bid by Michigan's Department of Transportation (MDOT) and awarded to CL Trucking & Excavating, LLC. Of this amount the City was successful in receiving a $530,000 grant from MDOT’s Transportation Improvement Program or “TIP”. The remainder is found within the current FY24 budget.

School starts August 30th, 2023. Bus routes use the South Street/Green Street and Seminary Street/Green Street intersections. Crews will maintain a lane of traffic at both intersections for the buses to complete their routes.

Timeline & Updates

  • June 26, 2023 - City Council Approves Engineering for the project
  • August 28, 2023 - Project estimated to begin with site prep and concrete removal
  • September 2, 2023 - Water Main and Sanitary Main Installation has begun.
  • September 15, 2023 - Water Main Tie-Ins and Individual water services and sanitary leads are being installed.
  • October 1, 2023 - Storm Sewer Installation is underway.
  • October 12, 2023 - Prep work for Concrete begins
  • October 23, 2023 - Grading for base course paving
  • October 30, 2023 - Top course finishes
  • November 2023 - Construction complete, street open to traffic.
  • December 2023 - Final walk throughs and checklists begin
